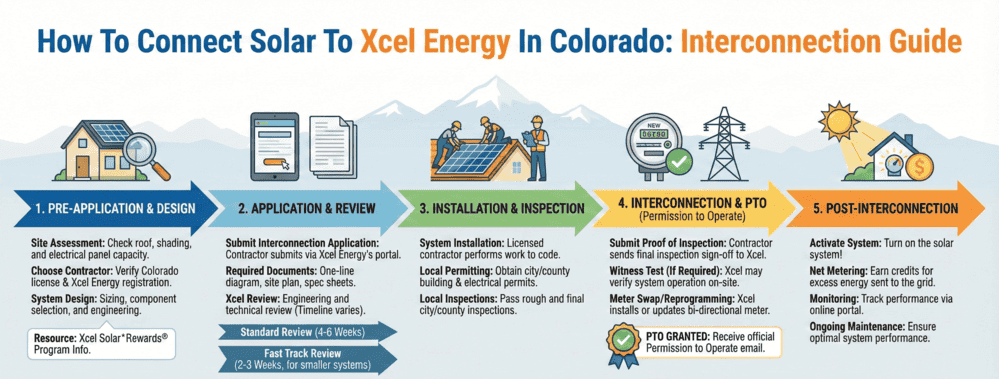

How To Connect Solar To Xcel Energy In Colorado: Interconnection Guide

The Xcel Energy solar interconnection process in Colorado takes 12-16 weeks on average for standard residential installations without required grid upgrades. This comprehensive timeline encompasses nine critical steps, from initial application submission through final Permission to Operate (PTO) authorization, all managed through Xcel Energy's Distributed Energy Resource (DER) Application Portal.

Key timeline breakdown for Xcel Energy solar interconnection:

  • Program Review: 2 business days after fee payment
  • Completeness Review: 10 business days for documentation verification
  • Engineering Review: 10 business days (under 25 kW) or 15 business days (25 kW and above)
  • Metering Installation: 20 business days after meter request
  • Total standard timeline: 12-16 weeks (3-6 months additional if grid upgrades required)

Application requirements include Xcel Energy Customer Account Number, Premise Number, Site Plan with property address, Line Diagram with system specifications (AC and DC capacity), application fees ($100 for Level 1 systems under 10 kW and $1,000 for Level 2 systems 10-250 kW), and final electrical inspection from local municipality.

Important: Xcel Energy strongly recommends not installing your solar system until engineering approval is complete to avoid costly modifications or delays. Your solar permitting manages the application process, submits all required documentation, and coordinates with Xcel Energy's Solar Team throughout the nine-step interconnection workflow. Upon completion, a red door hanger confirms Permission to Operate, authorizing immediate system activation and renewable energy generation.

Xcel Energy Interconnection Timeline

The standard utility interconnection timeline with Xcel Energy spans 12-16 weeks following your initial application submission, assuming no grid infrastructure upgrades are necessary. When upgrades become part of the review process, expect the timeline to extend by an additional 3-6 months. Xcel Energy strongly advises against installing your system until engineering approvals are complete.

Initiating Your Application

Solar installers typically handle applications through Xcel Energy's Distributed Energy Resource (DER) Application Portal. To protect your personal information, Xcel Energy requires installers to register with unique login credentials, a username and password. The individual overseeing your project should establish this account. After logging in, the application submission begins.

Required Application Materials

Your solar installer will collect the following information to initiate your application:

Application Details

  • Confirm your status as an Xcel Energy Electric customer
  • Specify your project location state
  • Program Selection: Xcel Energy provides multiple renewable energy programs. Review the interconnection options comparison chart (opens in new window) to identify the best fit for your needs

Exploring Your Renewable Energy Choices

As an Xcel Energy customer, renewable sources like wind and solar already contribute to your daily energy consumption. Those interested in expanding their renewable energy usage have multiple pathways available.

Subscription-based programs suit customers who prefer not to install equipment like solar panels at their property. These programs allow you to source a portion or all of your electricity from renewable generation for a modest monthly fee.

On-site installation programs apply when you're planning equipment installation at your location. On-site renewable systems deliver multiple advantages, including potential electric bill reductions and incentive payments when your production exceeds consumption. Following specific steps ensures smooth installation and interconnection.

Business customers can learn how these programs align with sustainability objectives by visiting the Renewable Resources for Businesses page.

  • Account Information: Your Customer Account Number and Premise Number appear on your Xcel Energy billing statement

Property Information

  • Property Address: Provide the complete address where solar installation will occur
  • Property Characteristics: Notify your installer if the property is a rental, new construction, has existing solar equipment, or will charge electric vehicles. These details are indicated through checkbox selections in the application
  • Access Considerations: Properties with locked gates or outdoor pets require special notation. Inform your installer of these conditions. When your application reaches Step 8, the Xcel Energy team will coordinate an appointment to expedite your solar-capable meter installation

Contact Details

  • Customer Information: Enter basic contact details, including full name, mailing address, phone number, and current email address (this email receives application status updates throughout the process)
  • Installer Information: Submit installer details including company name, primary contact, business address, and email address (this email receives application status updates throughout the process)

Application Costs

Solar installers typically cover application fees, though Xcel Energy allows customers to pay these costs directly.

Engineering Documentation

  • Site Plan: Must display the customer's complete name and property address
  • Line Diagram: Must include the customer's name, property address, and solar system specifications (both AC and DC capacity)

application roadmap

Already Submitted Your Application?

After your solar installer submits the application, several critical steps remain to finalize the interconnection request and ensure your system operates safely and reliably. Your solar professional manages most of these requirements through the online application portal.

Step 1: Application Initiation

The solar installer enters system specifications and customer contact information into the portal. The system automatically evaluates the 200% Rule for solar sizing (solar systems cannot exceed twice the site's annual kWh consumption). Manual evaluation by the Solar Team occurs within 3 business days when needed.

Upon completion, customers receive a welcome email outlining subsequent application steps.

Step 2: Program Evaluation

After receiving application fees, the Solar Team conducts a preliminary review of the Site Plan and Line Diagram within 2 business days. If information is missing, the solar installer must address the Solar Team's feedback and resubmit for review. Approved applications advance to engineering review.

Step 3: Completeness Assessment

Xcel Energy engineers evaluate the Site Plan, Line Diagram, and supporting documentation within 10 business days to verify compliance with Xcel Energy guidelines. Subsequent reviews follow a 10 business day timeline.

Step 4: Engineering Evaluation

Xcel Energy engineers perform comprehensive system reviews within 10 business days for systems under 25 kW AC and 15 business days for systems 25 kW AC and larger. Certain applications may require additional studies, extending review time and costs. Xcel Energy strongly recommends postponing installation until the application passes all engineering screenings.

Step 5: Study Requirements

When Xcel Energy identifies the need for additional analysis, such as a system impact study or required upgrades, the application enters the study process. Study fees and timelines vary based on complexity.

Step 6: Agreement Execution

Solar agreements are electronically transmitted to the customer/system owner and solar installer for signatures. Documents arrive at the customer email address on record. Xcel Energy countersigns within 2 business days of receipt. Paper signature requests may extend the countersignature timeline beyond the standard 2 business days.

Step 7: Construction and Design Finalization

The solar installer uploads the final electrical inspection from the local municipality and the NABCEP form (required for Solar*Rewards applications only) to the application portal. The Solar Team reviews final inspection documents and Solar Agreements within 3 business days.

Step 8: Metering and System Testing

The Solar Team requests meter installation when final inspection documents and Solar Agreements satisfy program requirements. A meter technician schedules meter installation/review within 20 business days of the meter request. If corrections are necessary for proper meter installation, the technician leaves instructions requesting you and your installer address issues before meter installation/review proceeds.

For properties with restricted meter access, notify your solar installer during the application process. The Xcel Energy Metering Team will contact you to schedule an appointment.

Step 9: Permission to Operate Authorization

Permission to Operate (PTO) represents the final process step, authorizing you to activate your system and begin benefiting from solar energy. The meter technician places a red door hanger confirming appropriate meters have been installed/reviewed and granting permission to operate.

Within several business days of completed meter installation/review, both customer and installer receive an automated portal email. Note that the secondary email notification is not required to energize your system; the red door hanger serves as the primary PTO confirmation.

Conclusion

Navigating the solar interconnection process with Xcel Energy in Colorado requires understanding multiple steps, from initial application submission through final Permission to Operate authorization. While the standard timeline spans 12-16 weeks, proper preparation and documentation can help ensure a smooth process. Working closely with your solar design team to gather accurate information, meet all documentation requirements, and respond promptly to any review feedback will minimize delays and expedite your path to generating clean, renewable energy. Remember that Xcel Energy's structured nine-step process exists to ensure your solar system operates safely and reliably while seamlessly integrating with the electrical grid. By familiarizing yourself with these requirements upfront, you'll be better prepared to transition to solar energy and begin enjoying the financial and environmental benefits of your investment. Understanding solar permitting best practices and working with experienced professionals can streamline your interconnection journey.

FAQs

How long does the Xcel Energy solar interconnection process take in Colorado?

The typical Xcel Energy interconnection process takes 12-16 weeks after initial application submission when no grid upgrades are required. If Xcel Energy's engineering review identifies the need for system upgrades or additional studies, the timeline may extend by an additional 3-6 months. Each step has specific review periods: Program Review takes 2 business days, Completeness Review requires 10 business days, and Engineering Review spans 10-15 business days depending on system size. The final metering installation occurs within 20 business days of the meter request.

What fees does Xcel Energy charge for solar interconnection in Colorado?

Xcel Energy charges interconnection application fees based on your system size and level. Level 1 systems (under 10 kW, typical for most residential installations) require a $100 Interconnection Study Fee. Level 2 systems (10-250 kW) incur a $1,000 fee, while systems between 250 kW and 2 MW require a $2,000 fee. These application fees are typically paid by your solar installer, though Xcel Energy allows customers to pay these costs directly if preferred. Additional study fees may apply if your application enters the study process due to required grid upgrades.

Can I install my solar system before receiving Xcel Energy approval?

No, Xcel Energy strongly recommends against installing your solar system until the application has passed all engineering reviews and screenings. Installing your system prematurely can result in costly modifications if the engineering review identifies issues or requires changes to your system design. Wait until you've completed Steps 1-4 of the interconnection process and received engineering approval before beginning physical installation. Your installer should coordinate the construction timeline with the application approval status to avoid delays and additional expenses. Reading essential solar energy books can help you understand the technical requirements better.

What is Permission to Operate (PTO), and how do I know when I receive it?

Permission to Operate (PTO) is the final authorization from Xcel Energy that allows you to activate your solar system and begin generating energy. You'll know you've received PTO when the Xcel Energy meter technician leaves a red door hanger at your property, confirming that appropriate meters have been installed or reviewed. This red door hanger is your primary PTO confirmation and authorizes immediate system activation. Within a few business days, you'll also receive an automated email confirmation from the application portal, though this secondary notification is not required to energize your system. Learn more about building your own solar power system and operational requirements.

Who submits the interconnection application to Xcel Energy—me or my solar installer?

Your solar installer typically manages the entire interconnection application process through Xcel Energy's Distributed Energy Resource (DER) Application Portal. The installer registers for portal access with unique login credentials and handles all documentation submissions, including the site plan, line diagram, application fees, and final inspection documents. While your installer manages the technical aspects, you'll need to provide essential information such as your Xcel Energy Customer Account Number, Premise Number, contact details, and property characteristics. You'll receive email updates throughout the process and will need to electronically sign Solar Agreements before receiving final approval. Professional solar permit services can help expedite this process.

What documents does my solar installer need to submit for Xcel Energy interconnection?

Your solar installer must submit several key documents through the Xcel Energy Application Portal. The primary engineering documents include a site plan displaying your name and property address and a line diagram showing your name, address, and complete solar racking system specifications (both AC and DC capacity). During the design and construction phase (step 7), the installer must also upload the final electrical inspection from your local municipality. If you're applying for the Solar*Rewards program, a NABCEP (North American Board of Certified Energy Practitioners) form is additionally required. All documents undergo review by Xcel Energy's Solar Team and engineers to ensure compliance with safety standards and grid integration requirements. For off-grid systems or specialized applications like battery pack installations, additional documentation may be necessary. Understanding renewable energy standards and proper solar panel disposal requirements ensures long-term system compliance. Organizations like Vote Solar provide additional resources for navigating interconnection processes and advocating for solar power optimization technologies. Check out our latest blog posts for more guidance on solar projects.

Contact us

Get in touch today

We are dedicated to providing top-notch solar permit services to homeowners, business owners, DIY, and solar installers. Contact us today.

Check - Elements Webflow Library - BRIX Templates

Thank you

Thanks for reaching out. We will get back to you soon.
Oops! Something went wrong while submitting the form.
Solar COMPANIES SUPPORTING
Solar Permit Solutions
Choosing Solar Permit Solutions means benefiting from our fast turnaround times, comprehensive packages, and dedicated support team.

We take the hassle out of the permitting process so you can focus on your solar installation.
Partners / Sponsors
